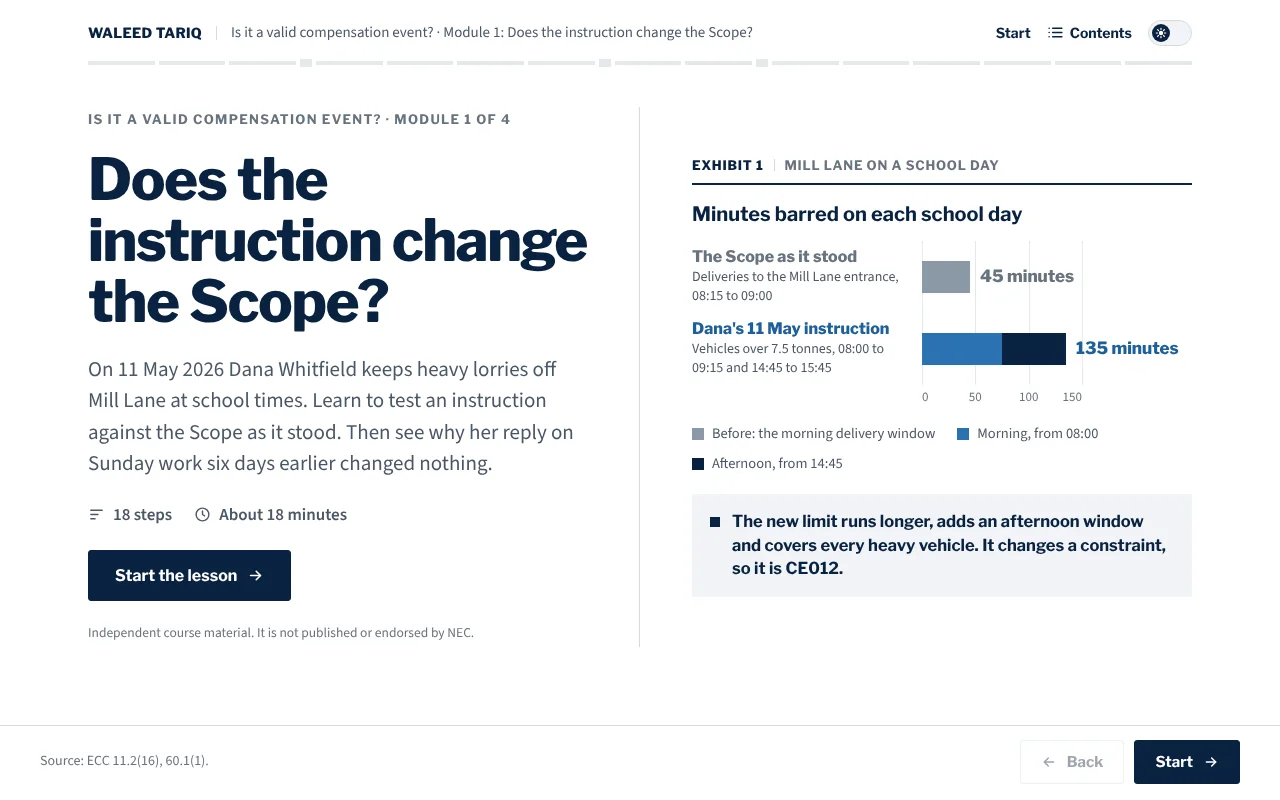

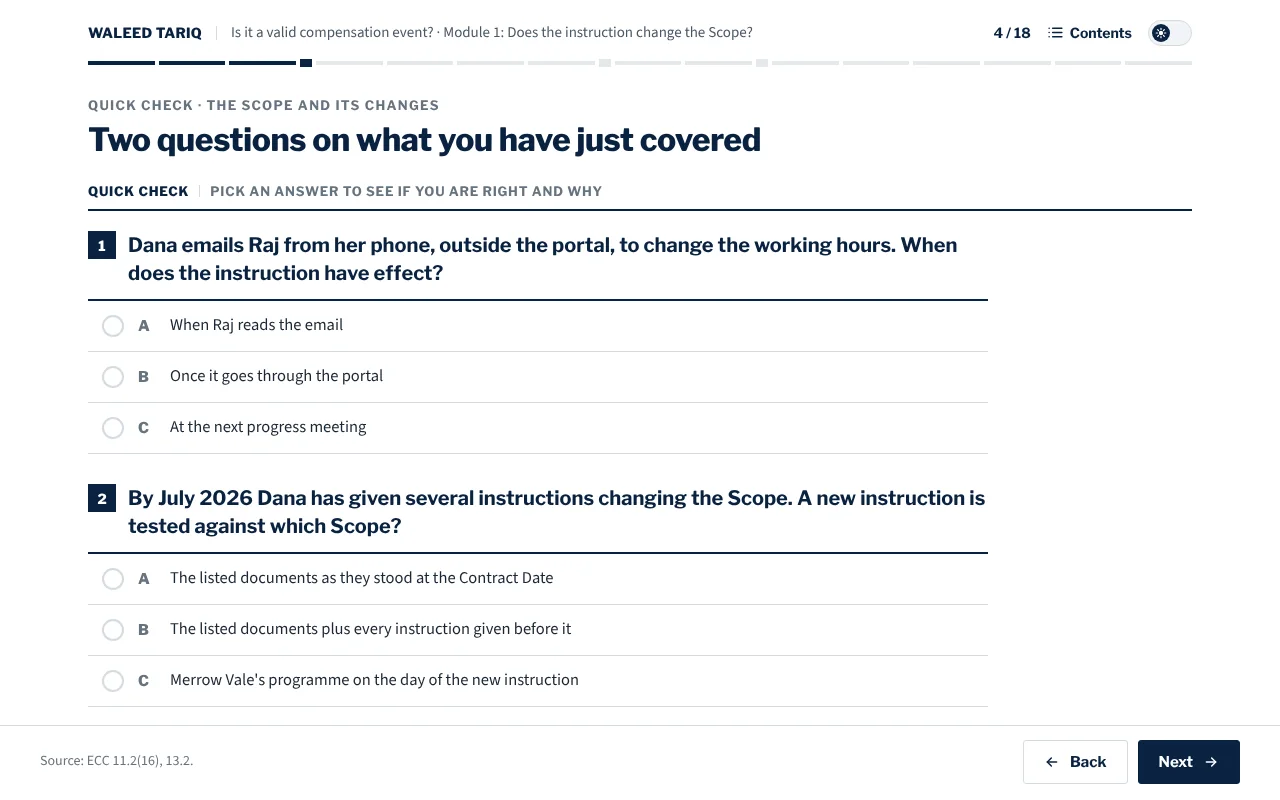

Four events on the Aldermere scheme, and why each one counts or not
Every example happens on the invented Aldermere Flood Relief Scheme, with dates that follow the contract's time limits.

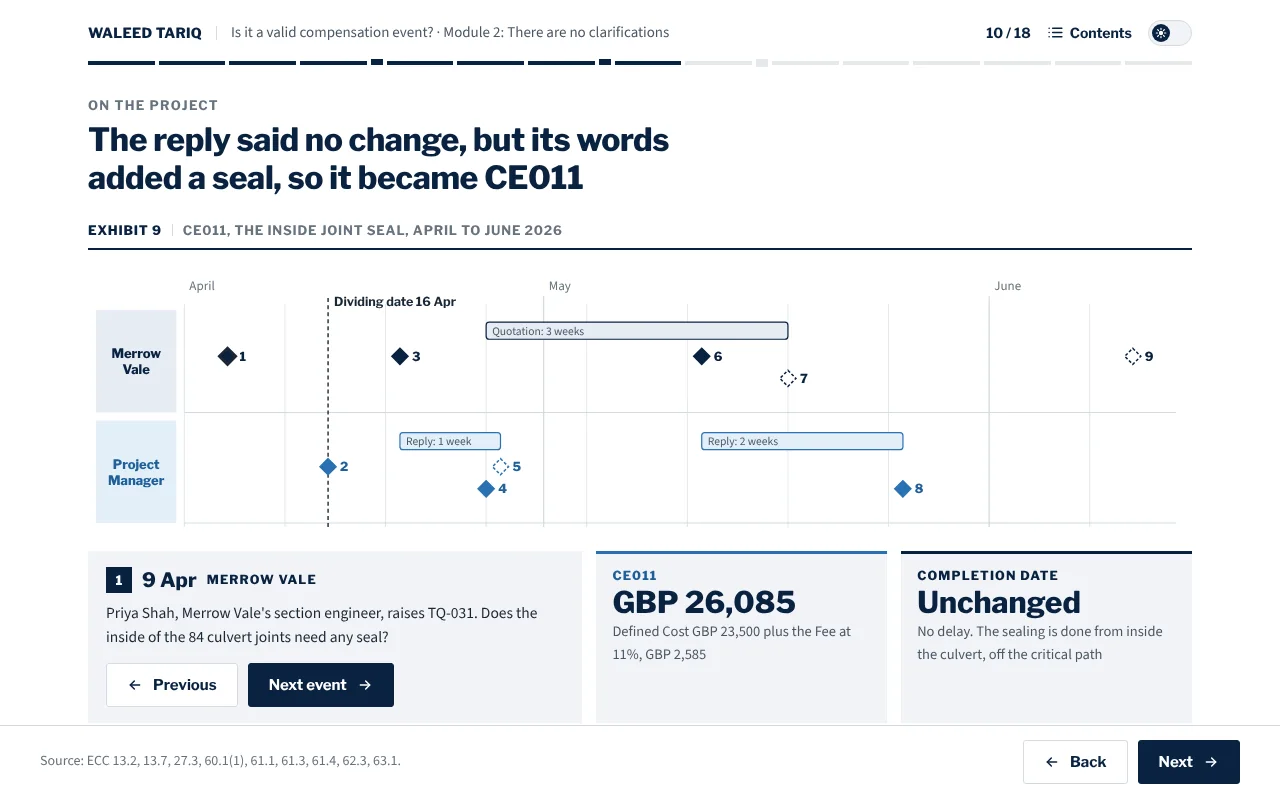

A portal reply headed "Clarification: no change" turns out to be CE011.
A drawing and the specification disagree about the outfall pipe bedding. Clause 63.10 decides who gets the benefit of the doubt.

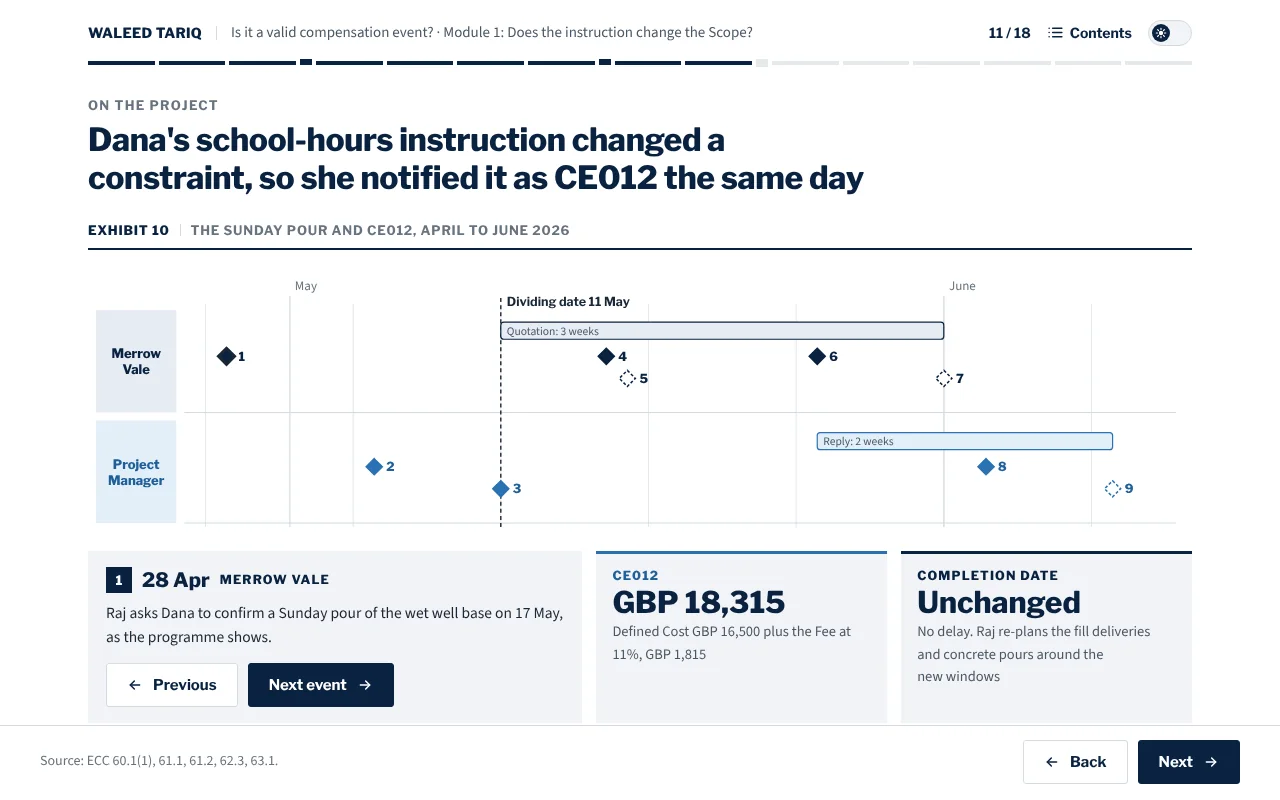

A thicker wet well base slab is not a compensation event, and the Project Manager's reply stands.
The Supervisor's guardrail direction becomes a compensation event only once the Project Manager instructs it.
